Express or stocked promotional items can ship in 24 to 48 hours, but realistically expect 5 to 10 working days for most fast-turn orders. Standard production runs around 10 to 20 working days, and indent or factory-direct custom items can take several weeks depending on decoration and shipping. The planning rule that saves every campaign: lock in artwork, MOQ, and delivery details early, then add a buffer. Promotional suppliers work these timelines daily across Australia.
TL;DR:
- Stocked products like pens, keyrings, or notepads can ship within 24 to 48 hours, but most fast-turn orders take 5 to 10 working days once proofing is included.
- Custom or indented items require several weeks, ranging from 3 to 12 weeks depending on complexity, with air freight adding 1 to 2 weeks and sea freight up to 8 weeks.
- Embroidered apparel generally takes 6 to 8 weeks due to digitising, sourcing, and machine time, whereas screen-printed apparel is faster at 2 to 4 weeks.
- Artwork readiness, order quantity, decoration complexity, seasonality, shipping method, and sample approvals significantly impact overall lead times.
- Confirming stock availability and supplier lead times before ordering helps avoid delays, especially for urgent or large campaigns.
Table of Contents
- Understanding promotional product lead times in Australia
- Lead times by product category
- What actually drives lead times up or down
- Building a realistic order timeline (with checklist)
- Express options and what fast turnaround really looks like
- A planner’s perspective on lead times
- Getting your timeline right from the start
- FAQ

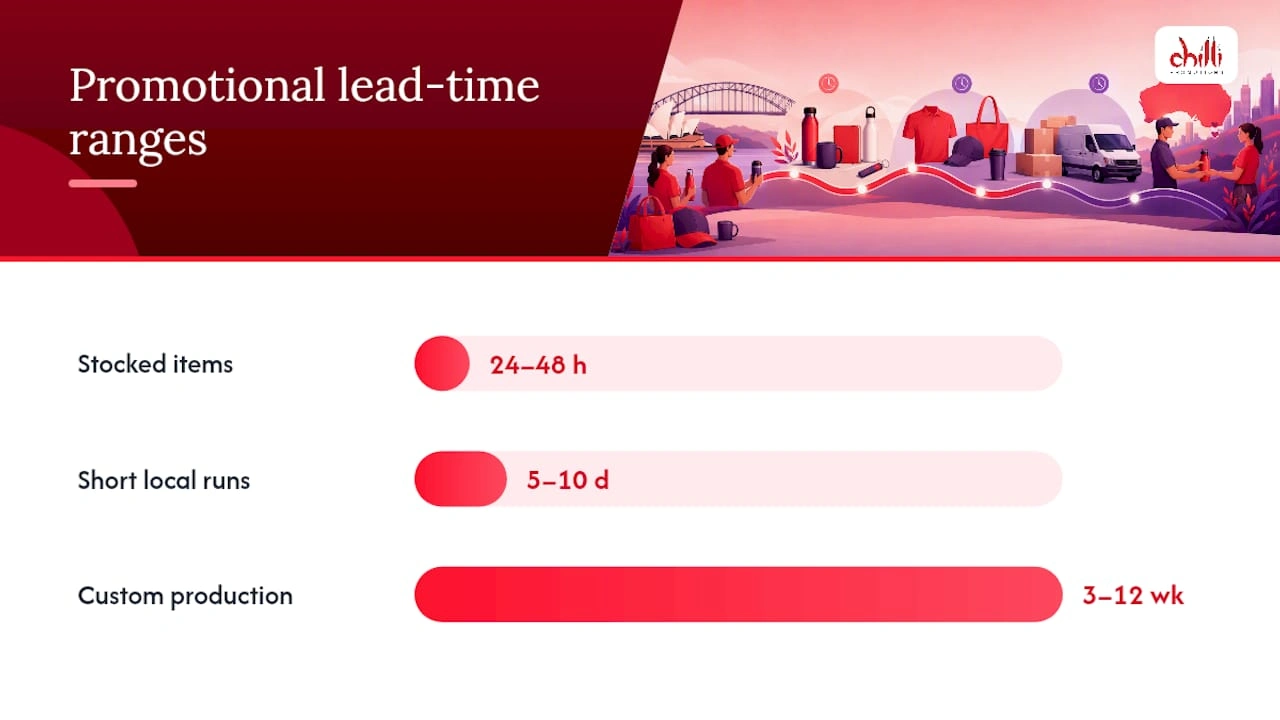

Understanding promotional product lead times in Australia
Suppliers generally sort jobs into three buckets, and knowing which one your order falls into changes how you plan the whole campaign.
Express or stock production covers items already sitting in an Australian warehouse, or simple local short runs using basic decoration like pad printing or single-colour branding. These typically move in 24 to 48 hours for genuinely stocked items, extending to 5 to 10 working days once you factor in artwork proofing and a short print run, according to Campbell Identification’s research on Australian promotional product timelines. Think branded pens, keyrings, or notepads pulled from existing stock.

Standard production is the workhorse category most bulk orders fall into. It involves sourcing blank stock, applying custom branding, and running quality checks before packing and dispatch. Industry guides put this at roughly 10 to 15 working days, though many Australian suppliers quote up to 20 working days once artwork approval cycles are included, per BrandConnect’s breakdown of promotional product lead times. Drink bottles, tote bags, and printed apparel commonly sit here.
Indent or factory-direct production means the item doesn’t exist yet in any warehouse. It’s manufactured to order, often overseas, then shipped and cleared through customs before it reaches you. This is where timelines stretch:
- Simple custom items with basic branding: 3 to 5 weeks
- Complex products (multi-material, multiple decoration points): 6 to 8 weeks
- Fully bespoke items requiring tooling or moulds: 8 to 12 weeks
- Add 1 to 3 weeks if sea freight is used instead of air freight
The category a product lands in isn’t fixed. A drink bottle can be express if it’s a stocked colourway with a single-colour logo, or indent if you want a custom mould and matched Pantone across the whole surface. Ask your supplier which bucket your specific spec falls into before you commit to a campaign date.

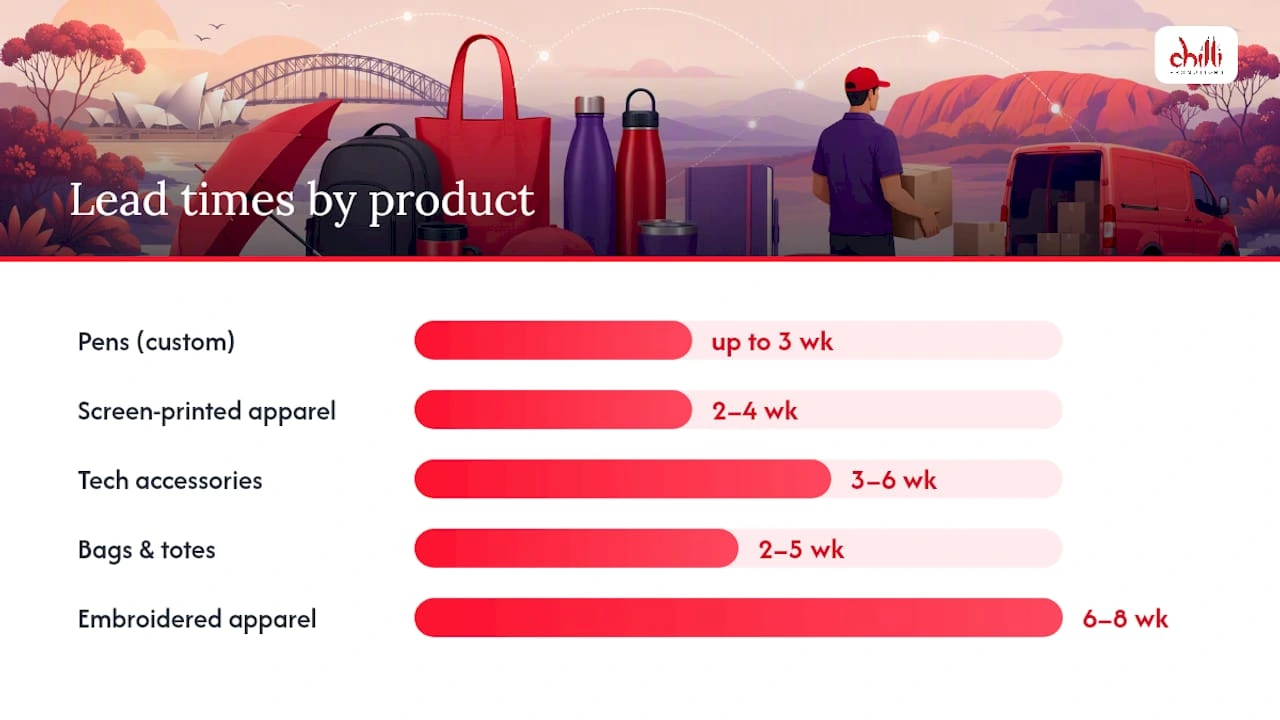

Lead times by product category
Different promotional categories carry different default timelines, mostly driven by the decoration method rather than the product itself.
- Pens and basic stationery: 3 to 7 working days for pad-printed logos on stocked pens; up to 3 weeks for custom colours or barrel shapes.
- Drinkware (bottles, mugs, tumblers): 7 to 15 working days for standard screen-printed or laser-engraved stock; 4 to 6 weeks for custom colours or indent shapes.
- Embroidered apparel: typically 6 to 8 weeks once digitising, garment sourcing, and embroidery run are included.
- Screen-printed apparel: faster than embroidery, usually 2 to 4 weeks for standard runs.
- Tech accessories (USB drives, power banks, cables): 3 to 6 weeks, longer if the casing itself is custom moulded rather than a stock shape with a printed logo.
- Bags and totes: 2 to 5 weeks depending on fabric sourcing and print complexity.
- Eco and sustainable merchandise: often 1 to 2 weeks longer than standard equivalents, because certified or carbon-offset stock is a smaller pool to draw from.
Pro Tip: Embroidered apparel is one of the most consistently underestimated categories. Digitising a logo into a stitch file, sourcing the right garment colour and size run, then scheduling embroidery machine time all stack up. Budget 6 to 8 weeks minimum and you won’t be caught out closer to your event date.
Custom-branded USB drives and other tech accessories fall into the slower half of this list because casing tooling, even for a “simple” logo placement, adds weeks that flat items like tote bags don’t carry.

What actually drives lead times up or down
Six factors determine whether your order lands on the fast or slow end of any given timeframe, and most of them are within your control.
- Artwork readiness. Vector files (AI, EPS, or high-res PDF), correct Pantone references, and a single decision-maker for sign-off can save three to five working days compared with back-and-forth email approvals.
- Order quantity (MOQ). Smaller custom runs sometimes queue behind larger jobs on a factory floor, while bigger orders can actually move faster per unit because they justify a dedicated production slot.
- Decoration complexity. Embroidery, multi-colour full transfers, and multi-point branding all add machine time that single-colour pad printing or screen printing doesn’t.
- Seasonality. End-of-year corporate gifting, university Orientation Week intake, and major trade-show seasons (particularly March to May and September to November) all compress supplier capacity across Australia.
- Shipping and customs. Air freight from overseas factories typically adds 1 to 2 weeks; sea freight adds 4 to 8 weeks, plus unpredictable customs clearance delays.
- Sample and quality-check requirements. A pre-production sample sign-off, common for larger or higher-value orders, typically adds 5 to 10 working days before mass production even starts.
Pro Tip: If you’re deciding between two decoration methods and timing is tight, ask your supplier for the lead time on each option before locking your artwork. A 6-week embroidery job can sometimes become a 3-week screen-print job with almost no visual compromise.
Building a realistic order timeline (with checklist)
Two timeline templates cover most campaigns; which one you need depends on how much lead time you actually have.
Express campaign timeline (2 to 3 weeks out):
- Day 1 to 2: confirm product, quantity, and stocked availability with supplier
- Day 2 to 4: finalise and approve artwork
- Day 4 to 10: production and quality check
- Day 10 to 14: delivery, with 2 to 3 days buffer built in
Standard campaign timeline (6 to 8 weeks out):
- Week 1: brief supplier, confirm decoration method and MOQ
- Week 1 to 2: artwork proofing and approval (allow two proof rounds)
- Week 2 to 3: sample sign-off if required
- Week 3 to 7: production
- Week 7 to 8: delivery, plus buffer for distribution to multiple sites if relevant
Supplier guides commonly recommend building in contingency time of 10 to 20% on top of the quoted production window, which covers everything from courier delays to an extra proof round nobody planned for.
Before you send a purchase order, run through this checklist:
- Final artwork in the correct file format, with Pantone or CMYK colours confirmed
- Approved proof, signed off by one named decision-maker
- Confirmed final quantities (check against MOQ tiers, since quantity breaks affect both price and scheduling)
- Purchase order and payment terms settled
- Clear delivery instructions, including split shipments if you need product at multiple locations
- Sample approval, if your order requires one
Chilli Promotions’ own promotional product checklist for Australian businesses walks through each of these steps in more detail, and it’s worth running through before any quote request. Understanding minimum order quantities ahead of time also avoids a last-minute scramble to top up numbers once production is already scheduled.
Express options and what fast turnaround really looks like
A genuine 24 to 48 hour turnaround is real, but it applies only to a narrow range of stocked products with simple decoration and no customisation. Step outside that narrow lane and you’re back into the 5 to 10 day window, or longer.
- Stocked pens, keyrings, and simple drinkware with single-colour branding: genuinely fast
- Anything requiring custom colour matching, multi-point decoration, or a bespoke shape: not express, regardless of how it’s marketed
- Certified eco or carbon-offset stock: often a smaller SKU range, which can limit express choices
Pro Tip: When briefing a supplier for an urgent order, ask directly: “Is this item currently in stock in Australia, or does it need to be manufactured?” That one question separates a genuine 48-hour option from a standard job wearing an express label.
If you’re based in or shipping to a capital city, checking current express order options for Sydney or Adelaide gives a clearer picture of what’s realistically stocked near you before you commit to a date.
A planner’s perspective on lead times
The most common scheduling mistake isn’t a supplier missing a deadline. It’s a marketing team assuming “custom” and “quick” can coexist without a buffer, then locking an event date before checking artwork requirements. A logo that needs re-vectorising, or a Pantone match that takes two rounds to get right, can quietly eat five working days that nobody budgeted for.
The fix isn’t complicated: treat artwork approval as its own milestone with its own deadline, not an afterthought squeezed between “order placed” and “production starts.” Pairing that with MOQ guidance early in the conversation, rather than after a quote comes back, consistently shortens the real-world timeline more than chasing a faster courier ever does.
— Allissar Tawadros
Getting your timeline right from the start
Suppliers with extensive experience building promotional product campaigns often develop scheduling instincts that come from running thousands of campaigns in Australia, from university Orientation Week orders to end-of-year corporate gifting. Experienced suppliers aim to communicate realistic timelines upfront and build sustainable, carbon-offset options into plans without adding surprise weeks to delivery dates.

When you request a quote, expect three things back: a production timeline specific to your chosen decoration method, a sample offer if your order warrants one, and a clear delivery date with buffer already factored in. Browse our promotional products range to see what’s available now, or work through our planning checklist before you get in touch, so your first conversation with us starts from a production-ready brief rather than a blank page.
FAQ
How far in advance should I order promotional products in Australia?
For standard custom branding, it is advisable to order several weeks ahead; for indent or fully bespoke items, allow a longer lead time to accommodate shipping delays.
What’s the fastest realistic turnaround for branded merchandise?
Genuinely stocked items with single-colour branding can ship in 24 to 48 hours, though most express orders realistically take 5 to 10 working days once proofing is included.
Why do embroidered items take longer than printed ones?
Embroidery requires digitising the logo into a stitch file and scheduling dedicated machine time, which typically pushes lead times to 6 to 8 weeks compared with 2 to 4 weeks for screen printing.
Does a smaller order mean a faster delivery?
Not always. Smaller custom runs can queue behind larger production jobs, so checking MOQ requirements with your supplier early helps set accurate expectations.
What information should I have ready before requesting a quote?
Final artwork in a vector or high-resolution format, confirmed colours, target quantity, and delivery deadline, all outlined in Chilli Promotions’ promotional product checklist.
